top of page

Roosevelt Bridge

PROJECT

If you missed our Community Open House event on April 30, click the button to access the materials.

Get Materials

The Roosevelt Bridge on US-70, located in Bryan and Marshall Counties, Okla., is set to receive significant upgrades through federal and Oklahoma state funding to ensure it remains a safe and reliable crossing over Lake Texoma. The project will be delivered using a method called Modified Progressive Design Build — the first time this approach has been used in Oklahoma by the Oklahoma Department of Transportation. This method helps designers, contractors and ODOT work together more effectively. That can mean fewer delays, greater innovations and a more efficient process overall.



To limit disruptions for drivers, the existing bridge will remain open during construction to help keep traffic moving safely.



We are proud to make this important investment in southern Oklahoma. Our goal is to support safe, reliable travel for the communities who depend on this route — today and for generations to come.



Updates will be shared as the project moves forward.


Why This Project Matters

Built in 1942, the Roosevelt Memorial Bridge provides a crucial connection between Marshall and Bryan counties. Over the years, wear and tear have made repairs essential. This investment will:

1

ENHANCE SAFETY FOR DRIVERS AND PEDESTRIANS

2

ENHANCE FREIGHT, RECREATIONAL, AND TOURISM OPPORTUNITIES

3

SUPPORT ECONOMIC GROWTH BY MAINTAINING A RELIABLE TRANSPORTATION ROUTE


Why This Project Matters

Opened in 1945, the Roosevelt Memorial Bridge provides a crucial connection between Marshall and Bryan counties. Over the years, wear and tear have made repairs essential. This investment will:

The Roosevelt Bridge has reliably served travelers for nearly 80 years. As Oklahoma plans for the future, this project is an opportunity to modernize the bridge to better reflect today’s travel needs and safety features. The new design will improve the driving experience, create space for walking and biking, and support the region’s long-term growth — all while keeping the current bridge open during construction.


Why It Matters

Opened in 1945, the Roosevelt Bridge has served travelers for 80 years. As Oklahoma plans for the future, this project is an opportunity to modernize the bridge to better reflect today’s travel needs and safety features. The new design will improve the driving experience, create space for pedestrians and support the region’s long-term growth — all while maintaining traffic along U.S. 70 during construction.

What We’re Doing

A new proposed four-lane bridge will be built near the existing structure to better serve travelers now and into the future. Key design enhancements will include: improving long-term resiliency to extreme weather events, widening the roadway, adding lighting and updating safety features. Once complete, the new bridge will ensure a safer and more reliable route between southern Oklahoma's communities.

What This Will Accomplish

The new bridge will improve safety for all travelers. By strengthening the connection between local communities and popular destinations, the project will support tourism, create new opportunities for local businesses and help keep people and goods moving reliably across Lake Texoma.

1

Enhanced Safety

2

Improved Long-Term Resiliency

3

Improved Connectivity Supporting Tourism, Recreation and Local Economies

Project Overview

Bridge Photo 2 GS.jpg

Enhanced Safety Features for All Users

Improved Roadway Layout for Seamless Travel

State-of-the-art Structural Design for Enhanced Durability

Enhanced Safety Features for All Users

Improved Roadway Layout for Seamless Travel

State-of-the-art Structural Design for Enhanced Durability and Resiliency

Proposed Bridge Improvements

The project will focus on:

Proposed Concept Renderings

The Roosevelt Bridge timeline will be posted once finalized.
Thank you for your patience as we work to deliver a high-quality project for the community.

Project Timeline

The Roosevelt Bridge timeline will be posted once finalized.
Thank you for your patience as we work to deliver a high-quality project for the community.

Spring 2026

Pre-construction Community Open House

*Fall 2026

Construction starts

*Fall 2028

New bridge open to two lanes of traffic

Late Winter/Early Spring 2029

Community Open House

April 6, 2026

Commission approval for continuation of design and construction services

Summer 2026

Early construction, investigation, and site preparation

Late Winter/Early Spring 2027

Community Open House

Late Winter/Early Spring 2028

Community Open House

*Fall 2029

All construction complete and US-70 open to four lanes of traffic

*Anticipated

Release Request for Qualifications (RFQ)

September 9, 2025

Completed

Statements of Qualification (SOQ) Due

October 13, 2025

Completed

November 3, 2025

Completed

Accelerated Innovations and Collaboration Kick-Off*

November 10, 2025

Completed

Determination of Which Team Will Receive Design & Construction Task Orders

April 2026

Completed

Anticipated Notice to Proceed with Design Phase Services

April 2026

Planned

*Tentative Date

View definitions for some of the terms in the timeline. Early Activities Initial steps to prepare for the project, like gathering input, confirming funding and coordinating with agencies. Success Management Workshop A kickoff meeting where ODOT and project partners align on goals, expectations and key priorities to guide the work. PDB Procurement The process of selecting a design-build team for the project using the Progressive Design Build (PDB) approach. This includes qualifications review and proposal selection. Guaranteed Maximum Price (GMP) A budget cap that ensures the builder cannot charge more than a set maximum for completing the work. This helps protect public funds and reduce financial risk.

M
A
M
J
J
A
S
O
N
D
J
F
M
A
M
J
J
A
S
O
N
D
J
F
M
A
M
J
J
A
S
O
N
D

Procure Designer/
Builder

Nov. 1, 2023 - April 30, 2024

Completed

Finalize Preferred Alternative

May 1, 2024 - July 23, 2024

Completed

Finalize NEPA

July 24, 2024 - April 1, 2025

Completed

Preliminary Design

July 24, 2024 - Jan. 1, 2025

Completed

Complete 404

Jan. 22, 2025 - June 10, 2025

In Progress

Review/Approve Builder Estimate

Jan. 22, 2025 - March 25, 2025

In Progress

Final Design

Jan. 22, 2025 - Oct. 28, 2025

In Progress

Right of Way Acquisition

April 2, 2025 - Aug. 4, 2026

Planned

Utility Relocation

Aug. 5, 2026 - April 13, 2027

Planned

Obligate Construction Funding

April 2, 2025 - April 8, 2025

Planned

Release Request for Qualifications (RFQ)

September 9, 2025

Planned

Statements of Qualification (SOQ) due

September 26, 2025

Planned

Selection of Teams

October 6, 2025

Planned

AIC Kick-Off

October 13, 2025

Planned

Requests to Continue Due

February 4, 2026

Planned

Determination of Which Team Will Receive Design & Construction Task Orders

March 2, 2026

Planned

Anticipated Notice to Proceed w/ Design Phase Services

Late March 2026

Planned

Construction

April 9, 2025 - April 4, 2028

Planned

2025

2026

2027

2028

2029

Environmental Process

Design

Construction

Request for Qualification Release

Select Progressive Design Build Team

Current Progress

Design

Request for Qualifications
Release

June 16, 2025

Environmental Process

Construction

Execute Design / Construction
Task Order for
PDB Team

Current Progress

2029

2028

2027

2026

2025

Request for Qualifications Release

June 16, 2025

Planned

Environmental Process

May 2025 to October 2025

Planned

Execute Design / Construction Task Order for PDB Team

September 2025

Planned

Design

September 2025 to September 2026

Planned

Construction

October/November 2025 to October 2029

Planned

Bridge Photo 3.jpg

April 30, 2026 Open House Meeting Materials

View information from our previous open house event.

View Info

Resources

Bryan County
Chickasaw Nation
Choctaw Nation
City of Durant
Town of Kingston
US Congress
Marshall County
OK State Chamber
OK Trucking Association
SCORTPO
SODA

Letters of Support

Media Advisory - US-70 Roosevelt community open house.png

Community Open House April 30, 2026


Team Selected to Deliver US-70


Historic Next Step for US-70

Public Information

  • The existing Roosevelt Bridge, opened in 1945, no longer meets modern design standards for traffic capacity and safety. Replacing the bridge will improve reliability and provide a safer crossing for travelers on US-70.

  • Pre-construction work, such as surveying, inspections, and soil testing, is already underway. Additional efforts to prepare the site for construction will continue through the summer.

    Construction of the new bridge is expected to begin in the fall of 2026. Major construction will begin once design work and permitting are complete. Updates will be shared on this website as the schedule progresses.

  • Bridge replacement projects of this size typically take several years to complete.  Due to the Modified Progressive Design Build delivery method, it is anticipated that construction of the bridge will take approximately 3 years with completion tentatively scheduled for late 2029.

  • Yes. The existing bridge will remain open while the new bridge is built nearby, so drivers can continue traveling across Lake Texoma.

  • Drivers may occasionally see lane shifts, work zones or reduced speeds near the project area during construction. The project team is working to minimize disruptions and maintain traffic flow along US-70.

  • The replacement bridge will be constructed just to the south of the existing Roosevelt Bridge. This allows traffic to continue using the current crossing while the new bridge is being built.

  • The new bridge will carry four lanes of traffic, with two lanes in each direction, along with shoulders designed to improve safety.

  • Crews are conducting surveys, inspections and soil testing to collect the information engineers need to design the new bridge. Pre-construction work is anticipated to continue through the summer.

  • Widening US-70 to two lanes in each direction with a shared left-turn lane will require removing trees. Most tree removal will occur between the east side of Lake Texoma and Johnson Creek Road/Willow Springs Road. Trees will also be removed to create space for construction material and equipment in the temporary staging area. Since the project is located on land mostly owned by the Army Corps of Engineers, the project team has worked closely with them to address these impacts.

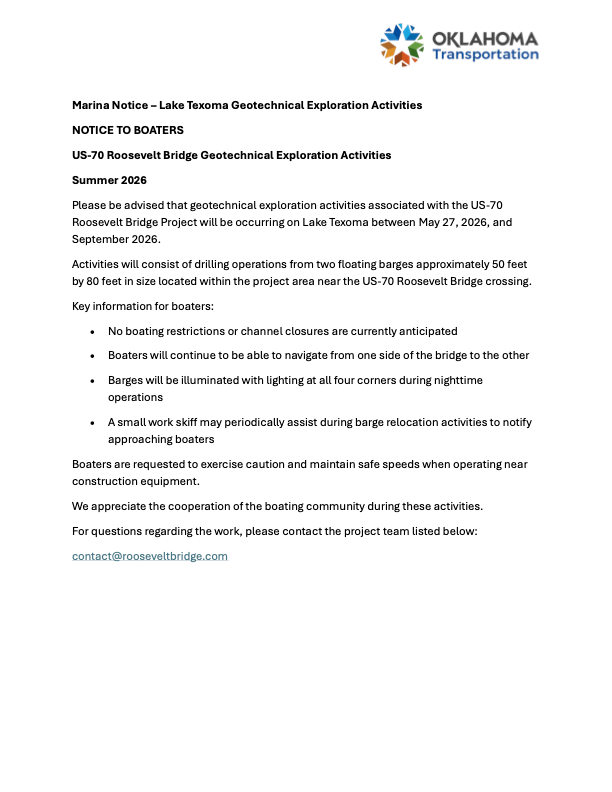

  • Lake Texoma will remain open during construction. Temporary safety zones may be placed around work areas on the water during certain phases of the project.

  • Options for removal of the existing bridge were evaluated and ODOT considered structural condition, cost and historic preservation requirements.  Once traffic has been shifted to the new bridge, ODOT plans to remove the existing bridge.  Specifics regarding the removal plans are still being developed.

  • Crews are using barges and support vessels for soil and subsurface work, as well as early utility work. Additional site preparation for the laydown area for materials and equipment will begin soon, but construction has not yet begun.

  • You may see workers doing surveys, soil testing or checking underground utilities. These are preparatory steps that ensure the site is ready before construction begins.

  • Some materials and equipment are being staged nearby to support survey work, soil testing and utility preparations. Having them close to the site helps crews work more efficiently once construction begins and should not interfere with current traffic.

Frequently Asked Questions

Stay Informed

We’re committed to keeping the public informed every step of the way. Check back for updates, construction schedules and any potential travel impacts.



For additional project details, visit the Roosevelt Memorial Bridge Project page.



To receive additional information or contact the public information team:

DRAFT
